02-24-2024, 05:43 PM
The car repair shop on the corner of king and stirling had all the cars towed away and the site fenced in this past week. The fences make it look like it might get demolished to me, otherwise why fence it in.
The Junction | 37 & 33 fl | Proposed
|
02-24-2024, 05:43 PM
The car repair shop on the corner of king and stirling had all the cars towed away and the site fenced in this past week. The fences make it look like it might get demolished to me, otherwise why fence it in.
02-24-2024, 08:34 PM
(02-24-2024, 05:43 PM)mastermind Wrote: The car repair shop on the corner of king and stirling had all the cars towed away and the site fenced in this past week. The fences make it look like it might get demolished to me, otherwise why fence it in. Both buildings on King (787 & 851) have demolition permits in the application phase but like many other projects they've been sitting in that status for months.
02-24-2024, 10:22 PM
(02-24-2024, 08:34 PM)ZEBuilder Wrote:(02-24-2024, 05:43 PM)mastermind Wrote: The car repair shop on the corner of king and stirling had all the cars towed away and the site fenced in this past week. The fences make it look like it might get demolished to me, otherwise why fence it in. Yes, I saw the notice to demolish the building at the corner of Queen and Charles said December 31 2023. So much for that, lol
02-24-2024, 11:18 PM
No projects in the Region will be starting until mortgage rates drop. Q condos has been approved for 3 years but hasn’t sold an until in forever. At least we have TEK and station Park C going up.
(02-24-2024, 11:18 PM)Lebronj23 Wrote: No projects in the Region will be starting until mortgage rates drop. Q condos has been approved for 3 years but hasn’t sold an until in forever. At least we have TEK and station Park C going up. Nothing is going to start for awhile, maybe some purpose built rental but even that's slow, certainly condos aren't going to sell. However, a lot of the prep work can be done instead, like demolition and permitting for shoring/foundations/balance of construction which is what we're seeing. In terms of projects with permit applications/issuances there's a bunch; Demolition Permits 332 Charles (Vive) 1001 King (Vive) 88 Queen (IN8) 455 & 485 Mill (Polocorp) 787 & 851 King (Lindvest) 149 Ontario Foundation/Shoring 926 King (Vive) The Metz Building A, B, C (Auburn) 206 Duke (Knossos Housing) 1295 Bleams Station Park 2B (VanMar) Balance of Construction 926 King (Vive) 88 Queen (IN8) The Metz Building A, B, C (Auburn) 197 Frederick (Rome Logistics) 530 King 1295 Bleams Station Park 2B (VanMar)
02-25-2024, 12:27 PM
455-485 Mill is active and I expect it to continue; this one is condos, but the demand for townhouse condos may be better than highrise ones at the moment.
Metz and some of the Vive projects should be proceeding (Vive is close to wrapping up the Victoria/Margaret project now), but those are rentals so they are not dependent on (investor) condo pre-sales, they can take more of a long-term view of the investments.
02-26-2024, 10:34 AM
(02-25-2024, 01:11 AM)ZEBuilder Wrote:(02-24-2024, 11:18 PM)Lebronj23 Wrote: No projects in the Region will be starting until mortgage rates drop. Q condos has been approved for 3 years but hasn’t sold an until in forever. At least we have TEK and station Park C going up. As someone who isn't very well-versed in how these buildings progress, are you able to briefly break down what these three categories generally entail? Thanks!
02-26-2024, 10:39 AM
(02-24-2024, 11:18 PM)Lebronj23 Wrote: No projects in the Region will be starting until mortgage rates drop. Q condos has been approved for 3 years but hasn’t sold an until in forever. At least we have TEK and station Park C going up. Not what i've heard. Spoke to someone recently and Q condos is the only project in the region getting regular sales, only received approval in summer of '23 as well
02-26-2024, 11:47 AM
(02-26-2024, 10:34 AM)SF22 Wrote: As someone who isn't very well-versed in how these buildings progress, are you able to briefly break down what these three categories generally entail? Thanks! Demolition just means they have a permit to demolish the current buildings on site. This basically means the site is ready for new construction. Foundation/Shoring permits allow for excavation of the site to occur as well as foundation works, alot of the time this also allows for all underground work to occur. However this varies by municipality. Balance of Construction allows for all above ground work to occur, for example at Elevate Condos they had balance of construction for Building A but only foundation for B and C which is why only Building A had above ground work occuring. There are obviously exceptions for example balance of construction doesn't include interior finishing for commercial units or the addition of magnetic locks on doors. So while it may allow the building to be completed there are other permits that are required for a building to be fully complete.
02-26-2024, 12:05 PM
(02-26-2024, 11:47 AM)ZEBuilder Wrote:(02-26-2024, 10:34 AM)SF22 Wrote: As someone who isn't very well-versed in how these buildings progress, are you able to briefly break down what these three categories generally entail? Thanks! Thanks for the clarification!
04-05-2024, 07:56 AM
Demolition is underway at the mechanic shop on the corner. I wonder if they will also knock down the colourful dots building now too, since they are already there.
04-05-2024, 09:50 AM
(04-05-2024, 07:56 AM)mastermind Wrote: Demolition is underway at the mechanic shop on the corner. I wonder if they will also knock down the colourful dots building now too, since they are already there. They have permits for the demolition of 5 Stirling Ave S, 787 King (mechanic shop) and 851 King (colourful dots) so realistically they'll all be gone.
04-05-2024, 09:24 PM
04-10-2024, 07:25 PM

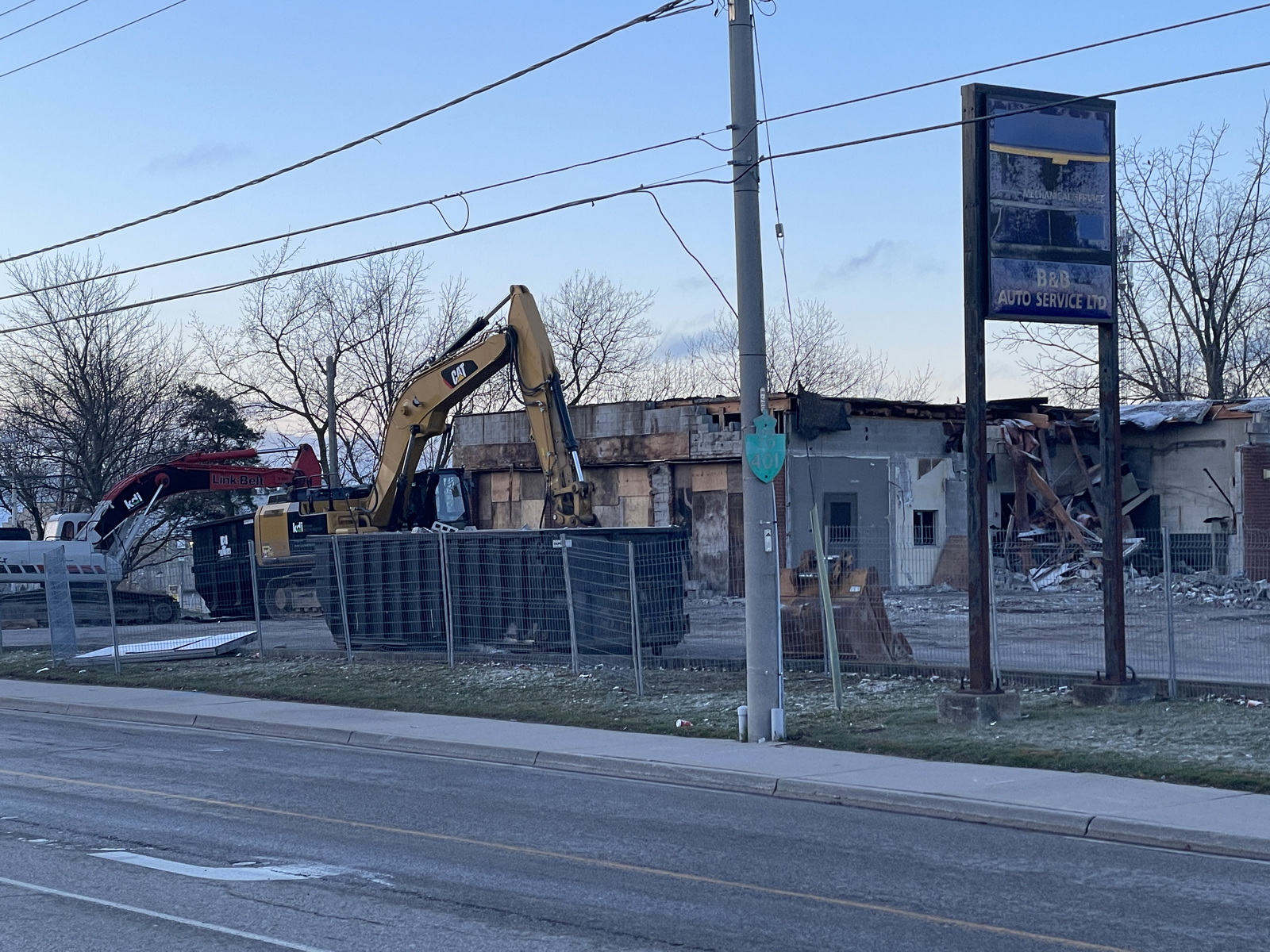

Going, going, gone!
05-10-2024, 08:20 AM
Driving by this morning I noticed 4-5 tents set up on this property, inside the fence. Nice place for an encampment.
|
